Abstract

This article uncovers the various aspects of Agile software development technique and Scrum framework to enable an Agile team/ team member to understand various issues any software development team sails through and how to overcome those challenges.

Where Did Agile Come from?

In 1970, Dr. Winston Royce presented a paper entitled “Managing the Development of Large Software Systems” which criticized sequential development.

He asserted that software should not be developed like an automobile on an assembly line, in which each piece is added in sequential phases. In such sequential phases, every phase of the project must be completed before the next phase can begin. Dr. Royce recommended against the phase based approach in which developers first gather all of a project’s requirements, then complete all of its architecture and design, then write all of the code, and so on. Royce specifically objected to this approach due to the lack of communication between the specialized groups that complete each phase of work.

Developing a Solution for Customers

Any software project starts from Gathering Requirements phase and many times what is developed is not exactly what the end user wanted, and many software projects fail during implementation.

Value Delivery Impediments

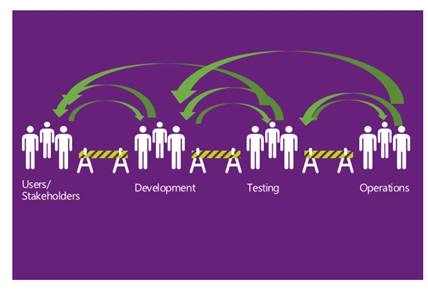

In today’s world teams have huge dependencies on various stakeholders of the project including Users <-> Developers <-> QA <->Operations etc. and it’s proven that we need regular communication and collaboration to deliver the value.

Any communication gap or lack of collaboration between these team(s) or individuals will have impact in following areas

Plan Driven Vs Value Driven Approach

Old school of software development has taught “waterfall” approach of software development. In waterfall approach, one phase’s output becomes input to next phase and those phases are distributed across the project timeline as shown in the image below.

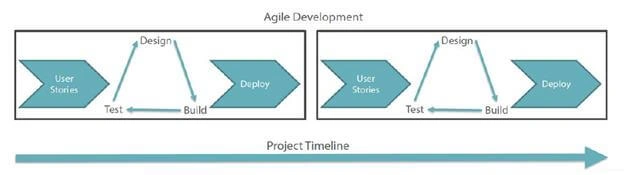

Today’s software development technique is “Iterative“ and “Incremental” I.e. Agile. In Agile, team run through all the phases within a Sprint as briefly shown in the image below.

In waterfall, development teams only have one chance to get each aspect of a project right. Whereas in Agile team has better understanding and learning from previous Sprint on what to emphasize upon and what to avoid to reap better results.

Why Agile

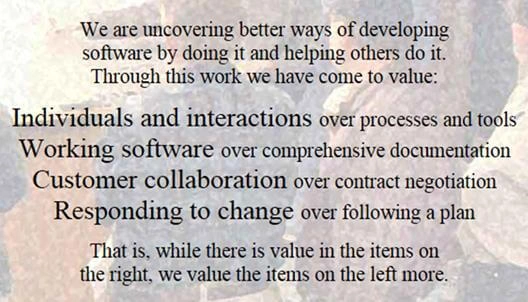

Agile Manifesto

Perfect Agile Team, does it really exist?

Success of any project depends on the team; I.e., it’s critical to have an awesome team to have rocking results. But in reality this doesn’t happen as team consists of individuals with their own attitude, aptitude, work style, ethics, behavior and issues etc.

Bruce Tuckman’s team development model is a perfect example how team can come together and start functioning.

Agile team’s success heavily depends upon “self-Organized” teams.

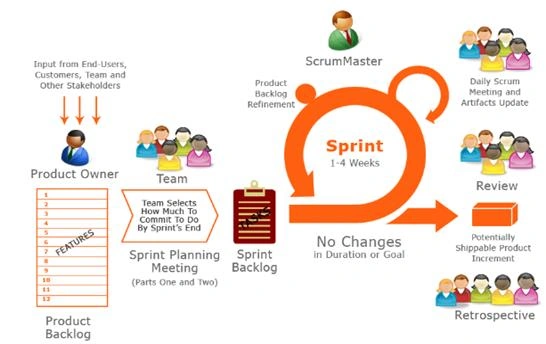

Scrum Process

Sprint Length and Team Size

Sprint is to Run at full speed over a short distance. Ideal Sprint length is 2 weeks. My recommendation is as follows and I have experienced that it really works well.

Most wanted thing in Agile – Velocity

Velocity is the amount of work team completes and delivers in each sprint. Ideal sprint duration is 2 weeks and highly recommend for any team.

I have seen better results when team works towards a pre-defined code complete date for instance, today is Tuesday and sprint is for two weeks, team can agree upon a code complete date of Wednesday of 2nd week; i.e., team will try to complete all the work by that day and have it ready for QA.

This just gives a deadline to accomplish the work, however there will be situations where work couldn’t get completed or even rolled over to next sprint and that is fine in some cases.

Here are some of my recommendations:

Give as much time as possible to Developers, SDETs and QA to fulfill their commitment. I.e. less meetings and hindrance.

Have at-least 2-3 sprints worth of work well-groomed and available for the team as “ready for development”. Two
reasons,

  1. At times for unforeseen reasons or instances a user story may be pulled out of current sprint. In such situations you lose story points you committed to. In such scenarios other US can be delivered.
  2. Sometimes team or an individual is able to complete the work early and available to pick more work, in such situation well-groomed loaded backlog can come very handy.

Groom Often (Backlog Grooming)

Ideally, grooming is a lengthy process and hence groom in short chunks and team lead can be present in the regular or small grooming sessions with PO or business and team can continue to focus on their work. However, team must be present at Sprint Planning time.

Brainstorm Together (Sprint Planning)

Daily Status Check

Just three things, no more; no less

I recommend, that if you have to discuss something related to a User Story or bug or someone reported a status on something etc. then “Post Scrum” that; i.e., discuss that when team has given the status and now you can drill into the detailed discussion.

Many times Devs start going into technical details of the issue, design of solution, architecture, code review comment details etc. during their status. This is not the right way of doing it. Just Post Scrum all that; if you have to discuss anything other than those three absolute musts.

I Am Blocked

It’s obvious that someone at some time is blocked on something. You can help, by asking just,

I will give you a scenario, let’s say I join a team which works on some third part control library for instance telerik or devexpress etc. and my license of that product is pending or not yet processed. Am I blocked. Well in a way yes, but I can use trial version up to 30 days and when my license information comes I can punch those.

Also, many times we just tell the other team that we are blocked on something and we are expecting the endpoint or JSON format etc. but we don’t always ask what is ETA and convey the timelines to which we have to adhere. If this has any impact on your team’s deliverable than you need to re-prioritize, escalate etc. so that either work is delivered to you on time or that user story is pushed to next sprint and you pick next item on Stack rank (priority) from the Product backlog.
Scrum Master must help you to get un-blocked.

Is there time to Think?

Many people and teams think that Agile has no time for following,

Well, there is and it’s called “Spike”. In agile software development, a “Spike” is a user story that cannot be estimated until a development team runs a time boxed investigation. The output of a spike story is an estimate for the original story.

Some examples of spikes,

  1. Discussing authentication mechanism and partner team’s flexibility to apply / accept those changes.
  2. Discovering or researching for an off the shelf solution work flow solution.

Technical Debt

Every team has it, generated it, accumulated it; not a problem. Just make sure you pay it off.

Technical debt is a term which is used for the work which the team or individual didn’t prioritize while pushing the deliverable, and requires improvements.

Read my detailed article on Technical Debt

Branching and Merging

Branching enables parallel development and delivery by providing each development activity a self-contained snapshot of needed sources, tools, external dependencies and process automation.

Continuous check-ins pollute the branch. Have a separate Release branch per Release.

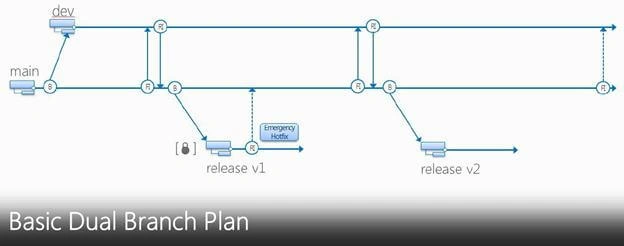

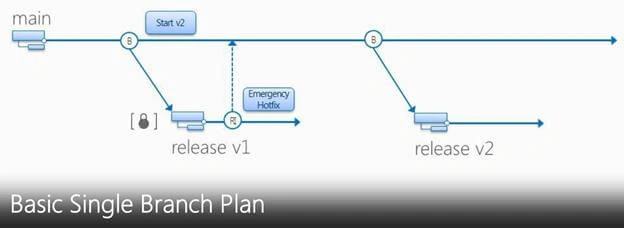

Basic Dual Branch is an Ideal branch plan, have a Main, spin a Dev branch for development and have RI (Reverse Integration) and FI (Forward Integration) to merge changes between Child and Parent branch respectively.

When you are ready to deliver the shippable product at sprint completion then spin a Release Branch and deliver the product out of that.

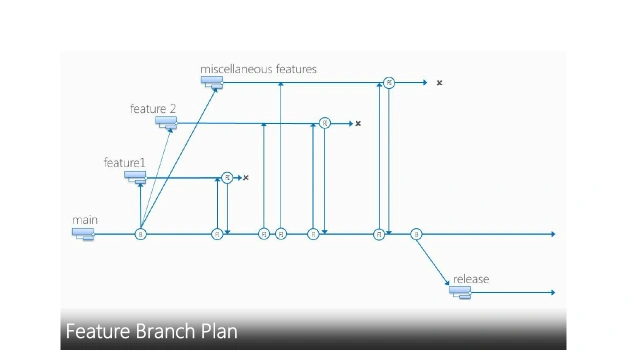

Feature Branch Plan is slightly complex and requires more merge efforts but at the same time it give entire isolation of work being done in a feature branch for entire time; until it’s ready for merge to Dev branch. One major issue with this plan is that your feature branch will have old and stale code and when you will Get Latest / Pull from the changes then you will get some conflicts etc.
Just saying

Unit Testing

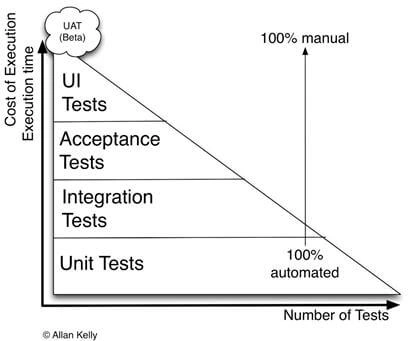

Many teams don’t invest in Unit Testing. For any Agile Team Unit Test is the most critical thing and team must continue to increase the code coverage of the tests. Even based on Test Triangle as shown in the image below, Unit Test has the larger scope in Software Testing

Benefits of Unit Testing
  1. Unit Testing gives an opportunity to think as User of your code, instead of an implementer of the production code.
  2. Reduce bugs by identifying all the use case scenarios to reflect intent (end user’s mindset, business needs, expected functionality and business validations etc.)
  3. Less-n-less time on debugging.
  4. Avoid collateral damage. I.e. a fix in one area may break functionality in another possibly
    related/unrelated area.
  5. Helps you achieve YAGNI- You Aren’t Gonna Need It. I.e. saves you from writing code which you
    don’t need

Tips for System Test

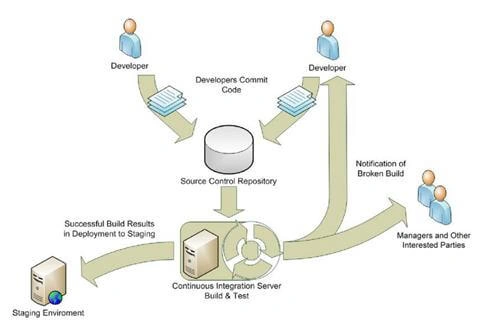

Continuous Integration (CI)

Advantages of CI

Successful Build

An aggressive goal for a successful build would include,

Let the Team see what is happening

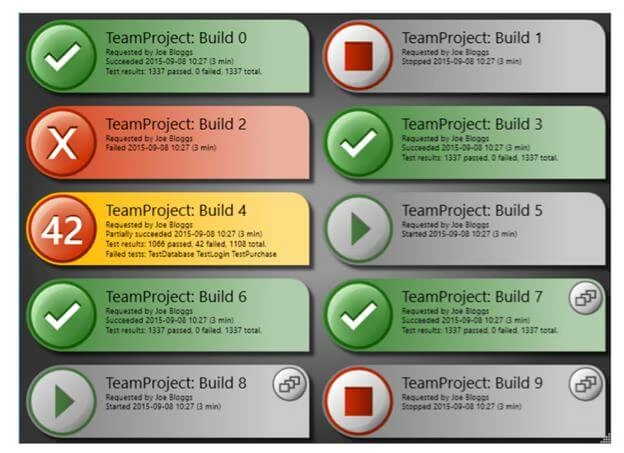

You can use this build monitoring tool from here.

Continuous Delivery (CD)

CI mainly focuses on development teams. The output of the CI system normally forms the input to the manual testing process and to the rest of the release process.

You’re doing continuous delivery when,
